Historical overview
Altay / New Altay is a Turkish main battle tank family and industrial program. It combines a conventional NATO-caliber 120 mm L55 smoothbore gun, a four-person crew, modern fire-control and sensor systems, modular passive and reactive armor, and an active protection system into a platform intended for the Turkish Land Forces. In project terms it is both an armored-force modernization effort and a defense-industrial-autonomy program: BMC states that its 2018 serial-production agreement covers 250 tanks and nearly 200 mostly local subcontractors, while SSB describes the system as an indigenously developed ALTAY MBT being delivered into Turkish Land Forces inventory. [S1; S4] Sources
Its significance lies less in a combat record, which has not yet been documented, than in the length and difficulty of the program. The Otokar-led design/prototype phase reached a first full-size model in 2011 and first prototype presentation in 2012, but serial production moved to BMC under a 2018 contract. The revised New Altay was publicly handed over for tests in April 2023, and BMC reports serial-production New Altay deliveries in October 2025. [S2; S5; S8] Sources
The most important variants and configurations are the Otokar-era prototype/PV line, the 2023 New Altay test vehicles, the Altay T1 initial production configuration, the planned T2/BATU follow-on configuration, and the Altay-AHT urban/asymmetric-warfare demonstrator. The cited accounts treats T2 as planned and AHT as a demonstrator rather than a fielded production standard. Sources
Major controversies and disputed points cluster around three topics: whether the vehicle is “in service” or still completing acceptance and ramp-up; how far the design is described as K2-derived rather than a Turkish national tank using South Korean design assistance and technology influence; and whether the domestic BATU power group is ready. The most careful reading is that the 2023 vehicles were test vehicles, initial serial-production deliveries began in 2025, the design has clear South Korean/K2 technology influence but is not simply a one-for-one K2 copy, and BATU’s engine milestone is real but the full domestic powerpack depends on transmission qualification. [S2; S5; S6; S7] Sources
Altay is a politically and industrially important modern MBT with strong published firepower, protection, and mobility claims. It remains less mature than long-serving peers such as Leopard 2, Abrams, and K2 because production ramp, unit-level reliability, logistics, BATU integration, and combat performance are not yet documented in open sources. Sources
By the late Cold War and post-Cold War eras, Türkiye operated a mixed armored force built around imported or modernized foreign-origin tanks, including M48/M60, Leopard 1, and Leopard 2 family vehicles. A national MBT promised more than a new turret and gun: it promised design authority, local armor and electronics work, local sustainment, and a platform around which the Turkish defense industry could build long-term armored-vehicle competence. [S1; S2] Sources
BMC’s program history says the decision to develop and produce a main battle tank domestically was taken in the 1996/1999 period, then converted into a project. It also records a 2000-era attempt to test foreign-origin tanks for possible domestic production, a 2004 feasibility stage, and a 2007 design-and-prototype procurement phase. Altay was not a sudden 2020s procurement; it was a long national-industrial project shaped by procurement delays, subsystem dependence, export-control problems, and the desire to localize critical elements. Sources
The military problem was straightforward but difficult: give Turkish armored units a modern MBT with high first-round hit probability, fire-on-the-move capability, night and thermal sights, modern command-and-control integration, modular protection, and long-term upgrade room. The industrial problem was even harder: establish a domestic prime-contractor and subsystem ecosystem for armor, electronics, powerpack, gun integration, and life-cycle support. [S1; S4; S5] Sources
Development and variants
Included are the original Altay design and prototype lineage, the BMC-led New Altay revision, initial production T1, planned T2/BATU follow-on configuration, operator status, industrial structure, and demonstrators that are part of the Altay family. Sources
Altay is properly classified as a main battle tank. The boundary issue is not whether it is a tank, but which life-cycle stage is being described. Open sources use delivery language in several ways: BMC and SSB describe the 2023 vehicles as delivered for tests, while later BMC language distinguishes 2025 serial-production New Altay deliveries. Sources
The AHT configuration is handled as an urban/asymmetric-warfare demonstrator within the family rather than a separate production tank. The T2 configuration is handled as a planned follow-on standard, especially associated with the domestic BATU power group, not as a fielded configuration unless and until future sources verify production deliveries. [S6; S7] Sources
The early project was Otokar-led. Otokar’s official heritage page records its 2008 selection as main contractor for the National Battle Tank Manufacturing Project, the first actual-dimensions Altay model in 2011, the opening of its tank testing center and first prototype presentation in 2012, and its 2016 offer to SSM for serial production. Sources
Published accounts describe these as Otokar-era prototype/pre-series vehicles used before the production contract and public New Altay deliveries. Sources
The program’s production center of gravity shifted in 2018. BMC’s official English Altay page states that the ALTAY Main Battle Tank Production Program was initiated on 9 November 2018 through a mass-production agreement between the Defense Industry Presidency and BMC, and that BMC would produce 250 ALTAY MBTs for the Turkish Armed Forces with nearly 200 mostly local subcontractors. Sources
This change did not merely restart production; it changed the public configuration story. BMC and SSB later described the New Altay as updated for modern battlefield conditions and as localizing or replacing many subsystems affected by foreign-procurement problems. The 2023 SSB article explicitly says many subsystems were localized, modern technologies were added, and the tank was redefined as “Yeni ALTAY.”. Sources

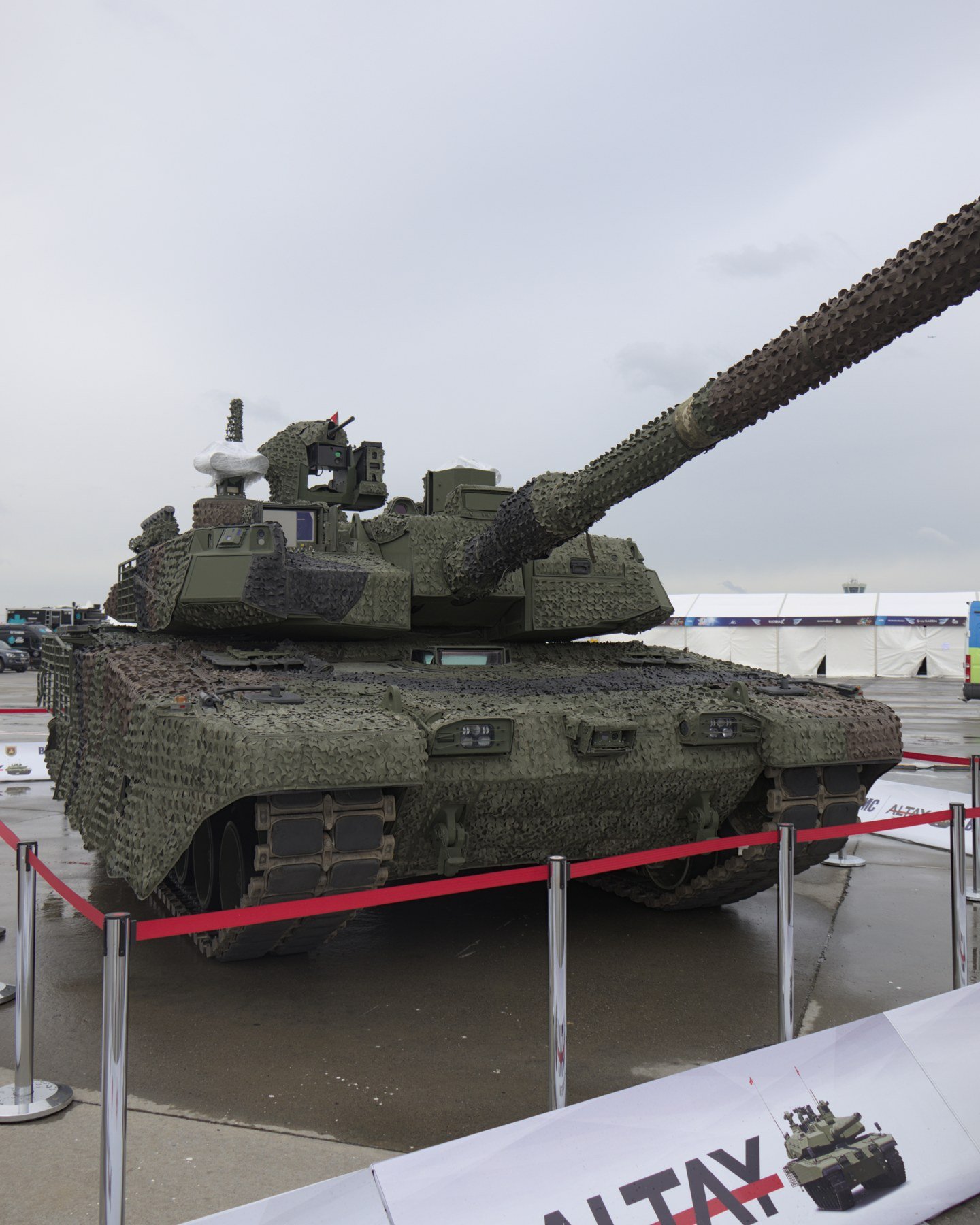

The public handover of two New Altay vehicles in April 2023 is a crucial but often overstated milestone. BMC says that, as of 23 April 2023, two Altay tanks had been produced and delivered to the Turkish Armed Forces for tests. SSB similarly frames the handover as delivery for completion of tests, saying the 3+ generation tanks would begin to enter inventory after Turkish Armed Forces tests were completed. [S2; S5] Sources
BMC later states that on 28 October 2025, at the opening of its Ankara Tank and New Generation Armored Vehicles Production Facility, serial-production New Altay tanks were delivered to the army. Published accounts describe 2025 as the stronger service-entry / initial serial-production milestone while retaining 2023 in. [S2] Sources
The powerpack question became a defining program issue. SSB states that initial serial-production deliveries would use power groups procured from the Republic of Korea, with later production to continue after completion/qualification of the domestic 1,500 hp BATU power group. BMC Power’s BATU page describes BATU as a 1,500 hp engine, transmission, and cooling-package development project, with a V12 engine first fired in 2021 and testing/qualification work continuing. [S5; S6] Sources
A January 2026 BMC Power announcement says the 1,500 hp BATU engine’s factory acceptance activities were completed, while the transmission qualification process was beginning or continuing. Anadolu Agency, citing SSB, similarly reported that the BATU motor acceptance tests were complete but transmission testing and qualification were still under way. Sources
Design and performance
Altay follows a conventional Western-style MBT layout: driver in the hull, three-person turret crew, main gun in a manned turret, engine/transmission at the rear, and a four-person crew consisting of commander, gunner, loader, and driver. BMC’s Turkish technical page identifies those four crew positions. Sources
Official open sources do not publish full hull armor geometry or dimensions. The hull is best described as a modern tracked MBT hull with modular protection, a rear powerpack, driver vision system, close-proximity surveillance, and crew escape arrangements. BMC lists a driver sight, close-proximity surveillance system, auxiliary power unit, embedded crew simulation, and crew escape hatch. [S2; S3] Sources
The turret is a manned four-crew arrangement with a 120 mm L55 smoothbore main gun, commander panoramic sight, gunner/commander thermal and TV sight channels, laser rangefinding, electric gun/turret drives, and a remote-controlled weapon station. [S2; S3] Sources
Armor thickness and exact composition are not published in the official open sources reviewed. BMC describes a national armor and ballistic protection design using composite, reactive, and cage/bar armor solutions, spall liner, optional/added mine protection, and a hybrid protection concept with the AKKOR active protection system. [S2; S3] Sources
The main armament is a 120 mm L55 smoothbore gun. BMC states that it can fire ammunition compatible with STANAG 4385 and has laser-guided tank-munition capability. [S2; S3] Sources
BMC lists a 7.62 mm coaxial machine gun and a remote-controlled weapon station able to use 12.7 mm and 7.62 mm machine guns or a 40 mm automatic grenade launcher, depending on fit. [S2; S3] Sources
BMC’s English technical page lists 40 rounds of main-gun ammunition storage. Exact ready-rack arrangement and ammunition compartment details are not fully documented in open official sources, though BMC/SSB discuss localized ammunition racks and an isolated hull ammunition rack. [S3; S5] Sources
BMC identifies Volkan II as the New Altay fire-control system and describes high first-round hit probability, hunter-killer capability, precise stabilization, automatic target tracking, laser rangefinding, TV/thermal sights for commander and gunner, and electric gun/turret drives. Sources
Published systems include a 360-degree independent/panoramic commander periscope, TV/thermal sight channels, laser rangefinder, driver sight, close-proximity surveillance system, and backup/secondary sight elements among localized subsystems. [S2; S5] Sources
The BMC Turkish technical page lists a 12-cylinder electronically controlled diesel engine with 1,500 hp and a 6-forward/3-reverse automatic transmission. SSB states that early serial-production vehicles use power groups sourced from South Korea, with later domestic BATU engine/transmission integration after qualification. [S2; S5] Sources
BMC lists electronically controlled in-arm suspension units, automatic track-tension adjustment, and hydropneumatic suspension/leveling features. Sources
BMC lists 65 km/h road speed, 45 km/h off-road speed, 30 km/h reverse speed, 450 km range, 1 m vertical step, 3 m trench, 60 percent grade, 30 percent side slope, and fording depths of 1.2 m unprepared, 2.2 m prepared, and 4 m underwater. [S2; S3] Sources
The four-person crew arrangement retains a human loader. New Altay vehicles are described as having embedded crew simulation/training capability, a C4I architecture, and digital systems intended to improve crew workload and situational awareness. [S2; S5] Sources
BMC lists a multi-band software-defined networking radio, a new-generation intercom, and a tank command-control communication/information system able to exchange data with other tanks and higher command elements. [S2; S3] Sources
Protection systems include modular armor, spall liner, AKKOR active protection, laser detection/warning, battlefield target identification, CBRN filtration and life support, fire and explosion suppression, smoke, and camouflage. [S2; S3; S5] Sources
Open sources do not yet provide independent unit-level reliability data for serial-production Altays. Official sources emphasize thousands of kilometers of endurance testing and more than 200 test shots with pre-prototype/test vehicles, but operational reliability in line service remains an unresolved question. Sources
The most documented weakness is not a published armor or firepower flaw but programmatic risk: long schedule delay, early dependence on foreign powerpack components, unresolved public detail about domestic transmission qualification, and limited open evidence of fleet-scale service experience. [S5; S7; S12] Sources
Production, operators, and combat record
BMC is the serial-production main contractor in the current public program. BMC states that the production program began with the 9 November 2018 agreement with the Defense Industry Presidency, that BMC will produce 250 tanks for the Turkish Armed Forces, and that nearly 200 mostly local subcontractors are involved. Sources
Altay is a system-of-systems localization program. SSB’s 2023 handover article lists localized or newly localized systems including 12.7 mm and 7.62 mm weapons, ammunition racks, turret ring gear, rotor, periscopes, auxiliary gunner sight, slip ring, manual firing system, pumps, road wheels, and cooling vest, while also emphasizing updated fire control, stabilization, laser rangefinding, and training/simulation capability. Sources
Powerpack production is the largest visible bottleneck. Initial production uses Republic of Korea-sourced power groups according to SSB. The domestic BATU project aims to supply a 1,500 hp engine, transmission, and cooling package. As of the January 2026 sources reviewed, the BATU engine had completed factory acceptance, but transmission qualification remained a continuing milestone. [S5; S6; S7; S12] Sources
The confirmed operator is Türkiye / Turkish Land Forces. BMC’s production page identifies delivery to the Turkish Armed Forces as the program objective, and SSB describes ALTAY MBTs as being delivered into the Turkish Land Forces inventory. Sources
No verified delivery to Qatar is documented in the official sources in the cited record, so Qatar is handled as prospective interest only, not as a confirmed operator. Sources
SSB reported that the New Altay test vehicles were delivered to complete Turkish Armed Forces tests and that the 3+ generation tanks would enter inventory after those tests. SSB also reported more than 200 shots and thousands of kilometers of endurance testing with pre-prototype/test vehicles. BMC later distinguished the 2025 serial-production delivery event. [S2; S5] Sources
No documented combat use of Altay / New Altay was found in the available accounts or the official sources reviewed as of 2026-06-04. The vehicle is reported as uncombat-tested in open-source historical writing. Sources
Likely tactical employment would mirror modern MBT roles: direct-fire armored maneuver, overwatch, combined-arms breakthrough and counterattack, and strongpoint reduction when supported by infantry, engineers, artillery, electronic warfare, and air-defense elements. That is an interpretive assessment based on MBT role and published capabilities, not a record of Altay combat experience. [S2; S4] Sources
The most relevant combat-history discussion is therefore comparative and anticipatory: the New Altay’s active protection, modular armor, thermal sights, hunter-killer capability, and C4I architecture are intended for a battlefield shaped by anti-tank guided missiles, top-attack munitions, loitering munitions, mines, urban ambushes, and networked fires. Open sources do not yet permit reliable conclusions about loss rates, survivability under fire, or crew experience. [S2; S5] Sources
Legacy and historical evidence
Altay’s most useful peers are K2 Black Panther, Leopard 2A7/A7V, and M1A2 SEPv3 Abrams. Sources
Altay’s legacy is already substantial as an industrial and procurement story. Even before a large combat record exists, the program has anchored Turkish ambitions in heavy armored-vehicle design, armor, fire-control integration, active protection, command/control systems, and heavy diesel powerpack development. [S1; S5; S6] Sources
Doctrinally, the program points toward a Turkish MBT that is not merely a replacement tank but a node in a modernized combined-arms force: connected by tank C4I, defended by active protection and laser warning, supported by embedded training, and designed for future modernization. [S2; S5] Sources
First, Altay is not documented as a combat-proven tank. Second, the 2023 handover cannot be simplified into full operational service. Third, BATU engine acceptance does not by itself prove that the complete domestic engine/transmission/cooling power group is fully qualified and installed across serial production. Fourth, “based on K2” cannot be reduced to “a K2 copy,” because the New Altay has a distinct Turkish subsystem and production story. [S2; S5; S7; S12] Sources
Manufacturer and SSB announcements document the major Altay milestones and stated equipment. Exact dimensions, protection levels, later T2 details, delivery quantities, and exports are less completely established. [S1; S2; S4; S5] Sources
Photographs and image credits
Background reading and references. Each photograph has its own source and credit.
Sources and further reading
Background reading and references. Each photograph has its own source and credit.
- [S1] BMC. “ALTAY” official English program page. Accessed 2026-06-04. Supported 2018 BMC serial-production agreement, 250-tank program, and subcontractor base
- [S2] BMC. “ALTAY TANKI / Yeni Altay” official Turkish page. Accessed 2026-06-04. Supported 2023 test handover, 2025 serial-production delivery event, program timeline, Volkan II, AKKOR, mobility, crew, weapons, and systems descriptions
- [S3] BMC. “Altay - Technical Specifications.”. Accessed 2026-06-04. Supported armament, fire-control, survivability, C4I, auxiliary systems, and performance values in the Altay section; page also contains other vehicle specifications and was
- [S4] Presidency of Defence Industries (SSB). “ALTAY MBT Serial Production Project.”. Accessed 2026-06-04. Supported official project description and delivery-into-inventory language
- [S5] Presidency of Defence Industries (SSB). “Yeni Altay Tankı Testler İçin TSK’ya Teslim Edildi.” 09 May 2023. Accessed 2026-06-04. Supported test handover, localization, AKKOR, Korean interim power group, BATU follow-on, and testing claims
- [S6] BMC Power. “BATU.”. Accessed 2026-06-04. Supported BATU as a 1,500 hp engine/transmission/cooling-package development project, V12 first firing in 2021, and ongoing qualification work
- [S7] BMC Power. “BATU Motorunun Fabrika Kabul Faaliyetleri Başarıyla Tamamlandı!” 02 Jan 2026. Accessed 2026-06-04. Supported BATU engine factory acceptance and transmission-qualification caveat
- [S8] Otokar. “Heritage.”. Accessed 2026-06-04. Supported 2008 Otokar selection, 2011 first actual-dimensions model, 2012 tank testing center and first prototype presentation, and 2016 serial-production offer
- [S9] Hyundai Rotem. “K2 Main Battle Tank.”. Accessed 2026-06-04. Supported K2 comparison data and technology-influence context
- [S10] KNDS. “Leopard 2 A7.”. Accessed 2026-06-04. Supported Leopard 2A7/A7V comparison data
- [S11] General Dynamics Land Systems. “Abrams.”. Accessed 2026-06-04. Supported Abrams SEPv3 comparison data
- [S12] Anadolu Agency. “ALTAY Tankı’nın yerli motorunda kritik eşik aşıldı.” 31 Dec 2025. Accessed 2026-06-04. Supported independent reporting of SSB statement that BATU engine tests were complete and transmission qualification continued
